Walk onto nearly any mid-duration manufacturing website, and you could pay interest the same grievance ultimately. A duct might not healthful wherein it’s supposed to go. A beam is sitting exactly where the plumber desired a riser. Someone, someplace, drew subjects within the same area, and no one caught it until steel had already been on the ground. That’s the tale BIM has emerged to rewrite.
Buildings are not smooth anymore. A unmarried ground can also bring structural framing, HVAC ductwork, electrical conduit, fire sprinklers, and plumbing lines, all competing for the same few inches of ceiling void. When those structures are designed one after the other, in separate offices, by separate teams who no longer frequently talk to each other in real time, collisions are nearly certain. BIM adjusts that equation by setting every device into one shared, sensible three-d model in which conflicts show up on a display screen instead of on a project website online on-line.
Why Clashes Happen in the First Place
Before diving into solutions, it helps to understand why those troubles keep taking place, even on projects run through professional agencies.
- Structural engineers design beams and columns based on load paths, not duct routes.
- Mechanical engineers design ductwork for airflow, frequently without seeing the final steel layout.
- Electrical and plumbing agencies work off older drawings that have not caught up with the present-day structural revision.
- Deadlines push teams to finalize drawings before every subject has reviewed the others’ work.
None of this occurs out of carelessness. It’s actually the man or woman of splitting a building into specialties. A dedicated coordination approach exists precisely to close that gap, catching the on the spot wherein a steel beam and a cross-return air duct determine they need the same six inches of space.
What This Coordination Process Actually Involves
At its middle, struggle detection is an assessment exercise. Software overlays the structural model atop MEP models and flags each factor where factors physically intersect. But it is no longer only a red flag and a shrug. A well-run technique includes grading clashes by severity, assigning them to the proper problem, and tracking selection through to sign-off.
There are normally 3 types of clashes well worth knowing:
- Hard clashes – Two robust gadgets occupying the identical physical area, like a duct running directly through a beam.
- Soft clashes – Objects that violate clearance or get entry to requirements, even though they do not technically touch.
- Workflow clashes – Sequencing conflicts, in which one exchange’s installation schedule blocks some one-of-a-kind’s get entry to.

Good clash reviews do not truly generate a list of red dots. They interpret what those flags suggest for time, schedule, price, and buildability, then hand contractors some issues they might act on before fabrication begins. This is where organizations offering Structural BIM clash detection Services earn their keep, turning raw geometry conflicts into a punch list someone can truly work from.
The Real Cost of Undetected Conflicts
Numbers have a propensity to make this argument higher than evaluations do. Rework added with the beneficial aid of discipline-located clashes automatically eats into mission budgets in ways that never show up in the precise estimate. An ignored war stuck at some point of framing may cost a few hours. The same battle stuck after drywall goes up? That’s demolition, re-routing, and a very unhappy today’s contractor.

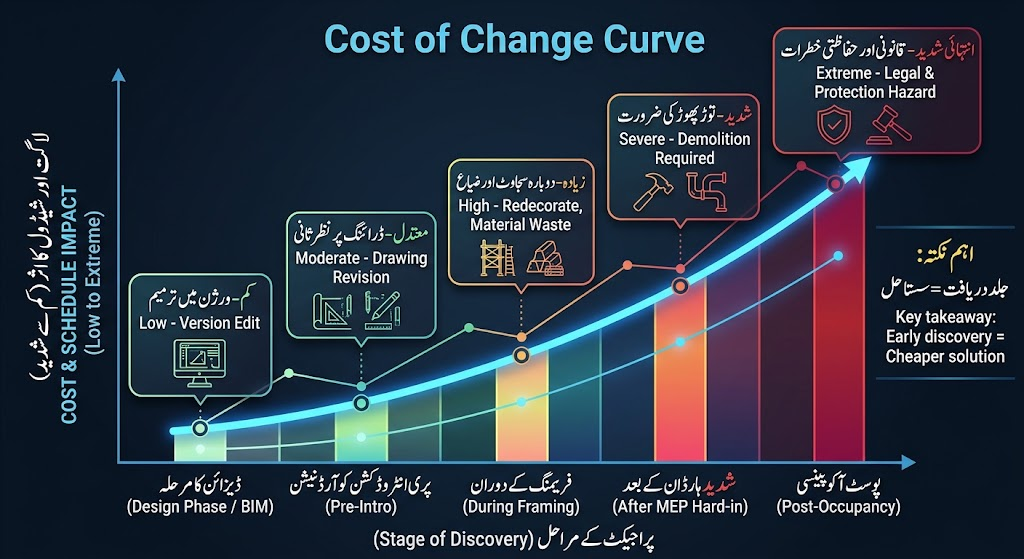

| Stage of Discovery | Typical Cost Impact | Schedule Impact |
| Design phase (BIM version) | Low – version edit best | None to minimal |
| Pre-introduction coordination | Moderate – drawing revisions | A few days |
| During framing | High – redecorate, material waste | 1–2 weeks |
| After MEP hard-in | Severe – demolition required | Weeks to months |
| Post-occupancy | Extreme – crook and protection hazard | Project popularity damage |
Where the Pricing Side of a Project Fits In
Clash detection does not stay in isolation. Once a version is straightforward, a person still has to price it, and this is where Estimating Services come into the workflow. Accurate quantity takeoffs rely on a coordinated version. If a duct, however,r overlaps a beam within the drawings, anestimate walkings off that same record would probably price materials, tough work, or metalonnage incorrectly, and that mistake follows the project all the way to the bid.

Think of it this manner: a conflict-free model is not just physically healthy. It’s the inspiration for each dollar decision that gets connected to the method afterward.
Tips for Getting Clash Detection Right
A few practices separate groups that seize troubles early from groups that don’t:
- Run clash checks continuously, not in reality as fast as in advance than advent documents are issued.
- Set clearance tolerances realistically, primarily based on real alternate get proper of entry to goals, not arbitrary rounding.
- Loop in fabricators early so that drawings maintain the coordinated model, not an outdated version.
- Assign ownership of every conflict to a specific person, with a closing date, not a general “a person will fix this” check.
- Re-run detection after each major version update, due to the fact that a single change can ripple into new conflicts in a few different regions.
Scaling this up to OPICSS too. On a small project, a handful of clashes is probably possible through email threads. On a health facility campus with a dozen experts, that method falls apart quickly. The cost-based clash detection scales nearly exponentially with assignment complexity, because the number of possible intersections among systems grows the more systems you add.
An Example Worth Learning From
Picture a six-story mixed-use building in which the structural engineer sure deep transfer beams on the second floor to aid an open retail space underneath. The mechanical group, working from an earlier ground plan, routed a high-velocity duct directly through that beam’s region. Nobody noticed until the coordination assembly, where the federated BIM model flagged 11 separate intersections along that unmarried duct run.
Because the conflict changed into caught digitally, the mechanical crew without a doubt re-routed the duct throughout the beam pocket, such as more or much less eighteen inches of horizontal offset. Total cost of the repair: a few hours of re-decorating. Had this long gone ignored till framing had already been completed, the repair should have meant cutting into structural metal or rebuilding a phase of ductwork on-net website online, each of which brings actual safety and financial outcomes.

Electrical Systems Deserve Their Own Spotlight
Electrical conduit and panel placement often get less attention in conflict conversations than ductwork, but they cause just as much friction. Panels want clearance for code compliance. Conduit runs need to keep away from structural penetrations that were not intended for them. Pricing conduit runs, panel boards, and wiring as it should be calls for knowing the real routed route, not a placeholder line drawn in advance of coordination happening.
When structural and electrical models are checked against each one of a kind early, groups supplying Electrical Estimating Services can quantify materials with a long way greaterself-confidencen, because of the truth the drawings they are pricing definitely reflect what is going to get built.
Characteristics of a Well-Coordinated Model
A model that is sincerely equipped for development tends to share positive tendencies:
- Every location’s model is modern, no longer a model from 3 revisions in the past.
- Clash reviews are archived with decision notes, developing a paper trail.
- Clearances account for upkeep access, no longer in reality set up in the form.
- Fabrication-diploma detail exists earlier than keep drawings are finalized.
Read more: What are the Standard Picnic Table Dimensions in 2026?
Final Thoughts
Clash detection isn’t always a field to test before submitting drawings. It’s within the course of a discipline, one which separates tasks that run effortlessly from tasks that bleed cash on change orders. Framing and MEP systems will generally compete for the same physical space in a building; it’s miles actually geometry. What BIM gives is a way to resolve that competition on a display, months earlier than anybody picks up a torch or a wrench. The groups that address coordination as an ongoing conversation, in place of a one-time deliverable, generally have a tendency to finish obligations on budget and within the time frame. Everyone else finds out the hard way.
Frequently Asked Questions
Is conflictdetection mostt crucial for large business tasks?
Not genuinely. Smaller residential or maintenance obligations gain too, despite the fact that the dimensions of coordination are obviously one of a kind. Even a single-family home with a complicated HVAC layout can run into framing conflicts that a quick version test might seize in advance than framing crews begin cutting joists.
How often want to warfare detection be run throughout a mission?
Ideally, at each primary format milestone, not just once at the end. Models change continuously as engineers refine their systems, and a war that failed to exist last week can appear the instant a person updates a duct routing or adds a structural brace.
Does warfare detection replace the need for site coordination conferences?
No. It facilitates those meetings in place of replacing them. The software catches the geometric conflicts; however, humans still want to talk about exchange sequencing, get right of entry to domestic windows, and who’s responsible for resolving each flagged difficulty.
Can struggle detection improve cost estimating accuracy?
Yes, not all at once but considerably. When a model is coordinated and freed from overlaps, the quantities pulled for materials and difficult paintings replicate what’s going to truly be built, which means fewer surprises in some unspecified time in the future of bidding and fewer trade orders as soon as production starts.
